Footpath Planned Works 2025/2026

19 September 2025

Footpath plans
Footpath plans

Further footpath works around the Copper Coast will be completed as shown in the table below:

TownshipRoad NameExtentLength (m)TypeCompleted Date
MoontaRobert StreetFrances Terrace to Blanche Terrace1750Broom FinishMarch 2025
KadinaRussell StreetSouth Terrace – CBD roundabout550Broom FinishMay 2025
WallarooErnest StreetErrington Street - Irwine Street500Broom FinishJune 2025
WallarooStirling StreetClara Street to John Terrace390Broom FinishJune 2025
WallarooHughes StreetLydia Terrace to Spencer Highway330Broom FinishJuly 2025

WallarooMay StreetElizabeth Street to Owen Terrace150Broom FinishScheduled 2026
KadinaDoswell TerraceMine Street to Ewing Street300Broom FinishScheduled 2026

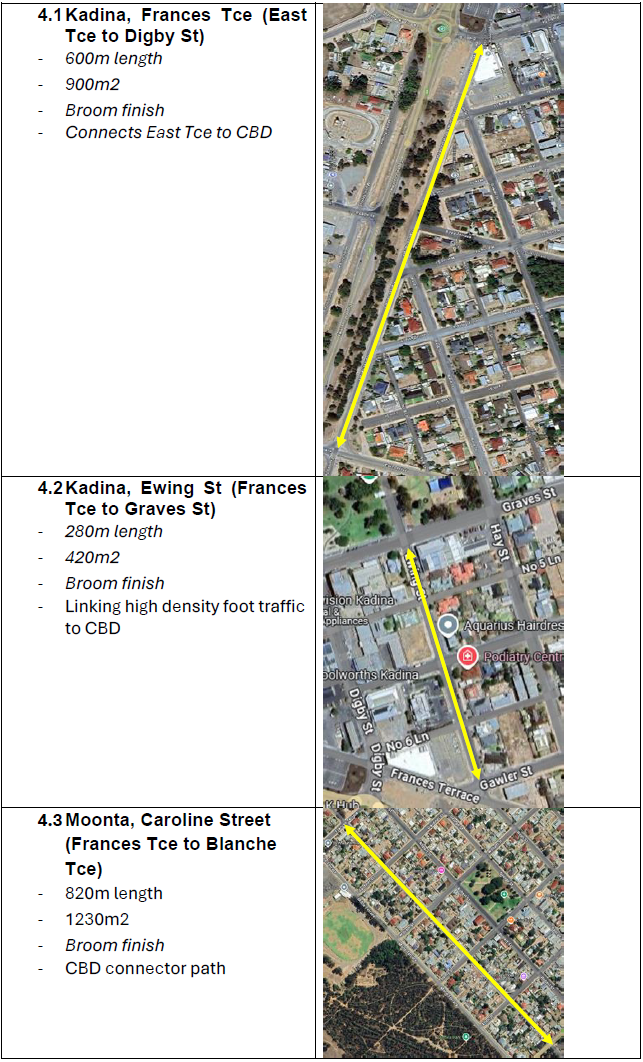

KadinaFrances TerraceEast Terrace to Digby Street600Broom FinishScheduled 2026
WallarooSeeley LaneFrom Wallaroo Primary190Broom FinishScheduled 2026
MoontaCaroline StreetFrances Terrace to Blanche Terrace1750Broom FinishScheduled 2026
KadinaEwing StreetFrances Tce to Graves Street280Broom FinishScheduled 2026
